Urgent requests have a way of taking over the workday. Messages arrive, deadlines move closer, and small tasks demand attention while important work keeps getting pushed to later.
The Eisenhower Matrix helps separate real urgency from work that matters over the longer term. Instead of treating every request as equally pressing, it places tasks into four clear groups based on two questions: Is this urgent? and Is this important?
That distinction makes it easier to decide what to do now, what to schedule, what to delegate or redirect, and what may not deserve attention at all.
Quick Overview: The Eisenhower Matrix
The Eisenhower Matrix is a task-prioritization tool that organizes work into four quadrants based on urgency and importance. It is also known as the Eisenhower Decision Matrix, Eisenhower Priority Matrix, or urgent-important matrix.
Its value comes from separating time pressure from meaningful impact. A recently arrived request may need a quick response without deserving much of your attention, while important work may need protection precisely because it has no immediate deadline.
The matrix is useful for sorting a mixed workload, but it is not a complete planning system. You still need to consider deadlines, consequences, dependencies, and available capacity when several tasks fall into the same quadrant.
Urgency and importance describe different qualities of a task. A task may need quick attention without contributing much to an important outcome, while valuable work may have no immediate deadline.
An urgent task is time-sensitive. Delaying it may create an immediate problem, block another person, or make the situation harder to resolve.
Common signs of real urgency include:
A task is not automatically urgent because it arrived recently or was labelled “ASAP.” When the deadline or consequence is unclear, ask what is needed, by when, and what will happen if it waits.
An important task contributes to a meaningful result. It may support a core responsibility, reduce risk, improve future work, or move a valuable project forward.
Important work often includes:
Importance is measured by the result the task supports, not by how visible, difficult, or time-consuming it appears.
Pressure may come from repeated messages, a senior person, or a request that sounds demanding. Urgency comes from timing and consequence.
| Pressure signal | Better question |
|---|---|
| “Can you do this ASAP?” | What is the actual deadline? |
| Several follow-up messages | What is blocked while this waits? |
| A request from a senior person | Does it outweigh current commitments? |
| A newly arrived task | What happens if it is handled later? |
This distinction matters because reactive work can easily crowd out tasks that have greater long-term value. Once urgency and importance are judged separately, the four quadrants become much easier to use.

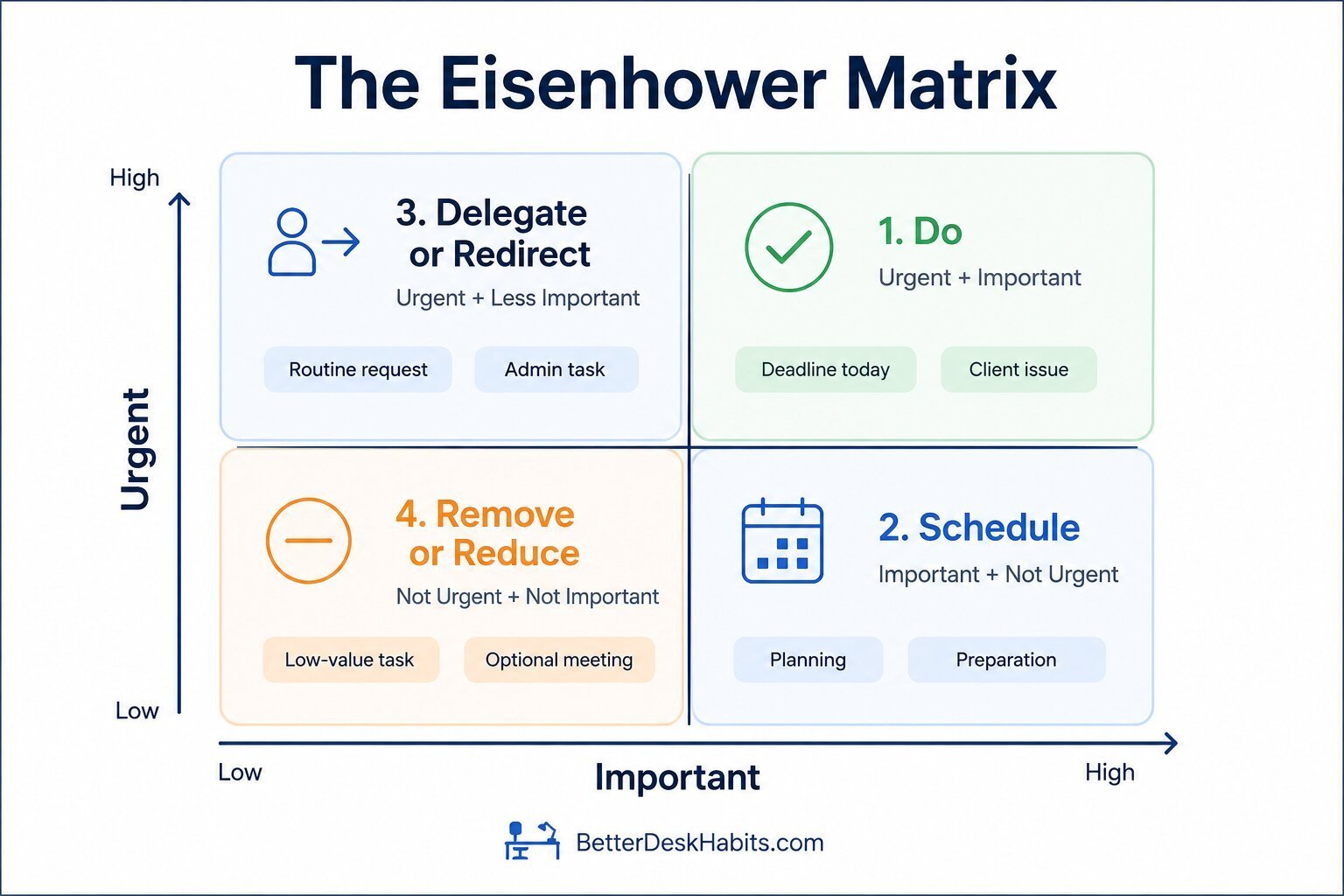

The matrix combines urgency and importance to create four possible actions: do, schedule, delegate or redirect, and remove or reduce.

Quadrant 1 contains work that needs attention now because it is both time-sensitive and tied to a meaningful outcome. Delaying it may create a serious problem, miss a firm deadline, or stop other work from moving forward.
Examples include:
These tasks should be handled first, but the quadrant should remain small. If most of your workload sits here, the issue may be unclear priorities, delayed planning, or more work than the available time can support.
Quadrant 2 includes work that matters but does not yet demand immediate action. This is where planning, preparation, improvement, and prevention usually belong.
Examples include:
This work is easy to postpone because there is no immediate pressure. Scheduling it protects valuable tasks from being pushed aside until they become urgent.
Quadrant 3 contains tasks that require a timely response but do not need your specific attention, authority, or expertise.
Examples include:
Delegate or redirect these tasks when possible. If delegation is not available, look for a faster or more limited way to handle them without allowing them to displace higher-value work.
Delegation still requires a clear handoff. Include the expected outcome, deadline, relevant context, and the authority the new owner needs to complete the task. Passing along an unclear request may create more follow-up work rather than reducing it.
Quadrant 4 includes tasks that have little effect on meaningful outcomes and no clear time-sensitive consequence.
Examples include:
These tasks should be removed, reduced, automated, or left inactive. The purpose is not to eliminate every minor task, but to stop low-value work from consuming attention simply because it is familiar or easy to complete.
Bring together the work that is currently competing for attention. This may include tasks from email, team messages, meeting notes, project tools, and your existing to-do list.
Keep future ideas and optional improvements separate from active commitments. The matrix is most useful when it reflects work that may realistically need action, scheduling, delegation, or removal.
The same task may not carry equal weight in every job. A client issue may be urgent for an account manager, while a system outage may take priority for an IT team.
Before sorting tasks, decide what urgency and importance mean in your work. Consider:
This prevents the matrix from becoming a vague exercise based only on instinct.
Compare each task against two questions:
Use the answers to place the task:
When a task does not fit clearly, clarify the deadline, consequence, or ownership before assigning it.
The matrix only helps when every category leads to a decision.
Complete Quadrant 1 work first. Give Quadrant 2 tasks a place on the calendar rather than leaving them on an open-ended list. For Quadrant 3, identify the right owner or a more efficient way to respond. Remove, simplify, or stop Quadrant 4 work.
Time blocking may help protect important Quadrant 2 work after you have decided what deserves scheduled attention.
Sorting tasks does not create additional hours. Account for meetings, recurring responsibilities, breaks, and the focused time each priority requires.
If the selected work does not fit, one or more commitments may need a later deadline, smaller scope, additional support, or a different owner. This is especially important when several tasks land in Quadrant 1.
A task does not stay in one quadrant permanently. A deadline may move closer, a dependency may appear, or new information may increase its importance.
Review the matrix when the workload changes rather than rebuilding it after every message. A useful update should reflect a real shift in urgency, importance, ownership, or available capacity.
The matrix does not need to contain every minor email, reminder, or two-minute action. Use it for responsibilities that genuinely compete for time or require a priority decision. Adding every small task may make the matrix harder to review without improving the choices it supports.
Suppose your workday includes these seven tasks:
| Task | Initial concern |
|---|---|
| Correct a pricing error before a client proposal is sent | The proposal goes out today |
| Prepare slides for a meeting next week | The work is important but not immediately due |
| Reply to a routine status request | A response is expected soon |
| Approve figures needed by two coworkers | Their work cannot continue without approval |
| Review next quarter’s project risks | The task supports future planning |
| Attend an optional meeting with no clear role | The meeting is already on the calendar |
| Reformat an old internal document | The file still looks inconsistent |
The matrix becomes useful when each task is judged by both urgency and importance rather than by visibility alone.
Correct the pricing error before the proposal is sent.
This task has a firm deadline and a clear consequence. If it waits, the client may receive incorrect information.
Approve the figures needed by two coworkers.
The approval may take only a few minutes, but it is blocking important work. That dependency makes it both urgent and important.
Prepare the slides for next week’s meeting.
The presentation is not immediately due, but scheduling focused time now may keep it from becoming a Quadrant 1 task later.
Review next quarter’s project risks.
This work supports planning and prevention. It has no immediate deadline, but delaying it may increase future problems or reduce the time available to respond.
Reply to the routine status request.
The request is time-sensitive, but it may not require a detailed response from you. A brief update, shared dashboard, or team template may handle it without interrupting higher-value work.
Attend the optional meeting with no clear role.
If your presence is not needed for a decision, contribution, or follow-up, declining the meeting may protect time for more useful work.
Reformat the old internal document.
The task has no deadline and little effect on current outcomes, so it may be removed from the active list.
The final matrix might look like this:
| Quadrant | Tasks |
|---|---|
| Do | Correct the pricing error; approve the figures |
| Schedule | Prepare next week’s slides; review next quarter’s risks |
| Delegate or redirect | Routine status request |
| Remove or reduce | Optional meeting; old document reformatting |
This example shows why a short task is not automatically low priority and a calendar commitment is not automatically important. The correct quadrant depends on what the task affects, how quickly it needs attention, and whether your involvement is necessary.
The Eisenhower Matrix may still leave you with several tasks in the urgent-and-important quadrant. When that happens, the matrix has identified the problem but has not yet created a workable order.
Use these tie-breakers to decide what comes first.
Ask which task would create the most serious problem if it moved. A client-facing error, missed legal requirement, blocked project, or service disruption may carry more weight than an internal deadline with limited impact.
Two tasks may both be due today, but one deadline may be fixed while the other can move without meaningful harm. Confirm the actual flexibility instead of assuming every stated due date has equal weight.
A task should move higher when other people, decisions, or project stages cannot continue without it. Completing one approval or providing one missing detail may unlock several hours of work elsewhere.
Give greater weight to work tied to an important outcome or responsibility. Also check whether the task requires your specific approval, expertise, or authority. Work that another qualified person can handle may not need to remain on your immediate list.
A complex task may need to begin before a shorter one, even when it will not be completed first. Starting early gives you time to uncover missing information, technical problems, or additional dependencies.
A practical order is:
If the work still cannot fit, the issue is no longer only prioritization. A deadline, scope, owner, or resource decision needs to change. The broader process for prioritizing tasks at work may help you make that trade-off visible and communicate what must move.
Not everyone has the authority, team support, or available backup to hand off urgent but less important work. In that case, the aim is to reduce how much attention the task consumes.
Some requests reach you simply because you are visible or familiar with the issue. When another person or team is responsible, redirect the request clearly instead of carrying it by default.
Recurring updates, approvals, and routine questions may be handled faster with a saved response, checklist, or shared document. This keeps the work consistent without requiring a fresh answer each time.
When several small requests require the same type of attention, handling them together may reduce repeated switching. Task batching is especially useful for routine messages, approvals, and administrative work that does not need an immediate individual response.
An urgent request may not always require a complete solution. A brief acknowledgement, partial answer, or minimum necessary update may be enough until more important work is finished.
If the same low-value task keeps returning, question whether it needs to happen as often. A daily update may work just as well twice a week, while a recurring meeting may be replaced with a written summary.
For unavoidable Quadrant 3 work, decide how much time it deserves before starting. Time boxing may help prevent a routine task from expanding into the time reserved for more important work.
The purpose is not to ignore urgent requests. It is to handle them in a way that protects attention for work that has greater impact.
The Eisenhower Matrix works best when you need to separate reactive work from tasks that support longer-term goals. It is especially useful for mixed individual workloads where deadlines, requests, planning, and routine responsibilities compete for attention.
The matrix is useful for:
Its simple structure makes priorities easier to discuss with a manager or team because each task is connected to a clear action.
The matrix is less useful when:
In these situations, the matrix may identify the type of work without fully deciding what comes first. You may need a more detailed priority filter, project-planning method, or a conversation about deadlines, scope, and available support.
The Eisenhower Matrix is most effective as a decision aid, not a rigid rule. Its purpose is to make trade-offs easier to see, not to force every task into a perfect category.
Weekly Review
A Simple Weekly Eisenhower Matrix Review
The matrix works best when it reflects your current workload rather than the priorities you set several days ago. Use these questions during a brief weekly review:
There is no fixed number. Quadrant 1 should stay small enough to remain manageable, while Quadrant 2 will often contain more planned work. The matrix becomes less useful when nearly every task is placed in the same quadrant.
Review it at the start of a planning period and whenever a meaningful change affects a deadline, consequence, dependency, or owner. You do not need to rebuild the matrix after every new message.
Yes. A scheduled task may become urgent as its deadline approaches, while an urgent request may become less important once ownership or circumstances change. The matrix should reflect the task’s current situation.
Include recurring tasks when they compete for meaningful time or need a priority decision. Small routine actions that happen automatically do not need to be added unless they are crowding out more important work.
It may help a team discuss urgency, importance, and ownership using a shared structure. However, complex projects may also require dependency tracking, resource planning, and clearer decisions about who has authority to set priorities.
